What is a Neighborhood Greenway?

Neighborhood Greenways are low-speed, low-volume, shared-space streets that support high comfort walking and bicycling connections. Our 2019 Transportation Plan designates several City streets for the design and installation of Neighborhood Greenway facilities as part of the Priority Bicycle Facilities Network. To design and install Neighborhood Greenways, the City follows the Staff-led Traffic Calming and Neighborhood Greenways process.

More information on the Traffic Calming and Greenways process

More information on the Bloomington Transportation Plan


What should I expect?

Neighborhood Greenways are an important component of the community’s plans to support an improved quality of life and connectivity. Past Neighborhood Greenway projects have shown an increase in the number of people walking, rolling, and bicycling in the area.

Residents may still park and drive on the Neighborhood Greenway. Traffic calming devices such as speed bumps and bump outs reduce the likelihood that drivers will speed on these streets.



Project Map:

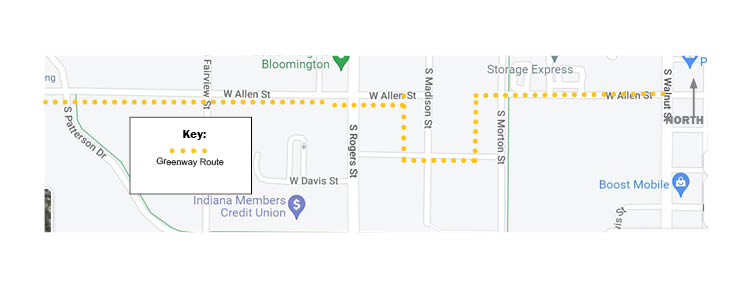

a map of the location for the W. Allen Neighborhood Greenway
Project Timeline:

1. Informational Neighborhood Letter: sent 3/22

2. Neighborhood Greenway Survey Completed

Note: Letters were mailed to residents within 300ft of the project - not 300m.

3. First Meeting: Project Scope & Objectives -Tuesday, April 5, 2022

4. Second Meeting: Design Review & Feedback:
    Monday, October 17, 2022

5. Open Comment Period: October 6 - November 14, 2022

6. Bicycle and Pedestrian Safety Commission Review: Approved on Monday, November 14, 2022

7. Installation: Spring 2023

8. Rogers St will be closed at W Allen St, May 22nd through May 29th. Detour will be along W Bloomfield Rd and S Patterson Dr.

9. Allen St Greenway Project Was completed on July 21st, 2023. This was at a final cost of $290.069.98 by E&B Paving.



How to Stay Involved:

Reach out to planning@bloomington.in.gov with any questions.

Bidding Documents:

Letting Date: November 21st, 2022, 12:00 PM

Zoom meeting link for Bid Opening- LINK

No pre-Bid meeting was scheduled for this project.

Award Date: November 22nd, 2022



Results:

Rivertown Construction, LLC: $298,426.00

E&B Paving, LLC: $290,00.00 (AWARDED)

Crider & Crider, Inc.: $320,386.75

Milestone Contractors: $344,300.00

Smock Fansler Corporation: $293,731.25



Project Contacts:

For questions regarding this project's construction impacts:

Jason Kerr, Project Manager, Engineering Dept

812.349.3913 or kerrja@bloomington.in.gov



For questions regarding this project's design and approval process:

Hank Duncan, Bicycle and Pedestrian Coordinator, Planning & Transportation Dept

812.349.3529 or hank.duncan@bloomington.in.gov



For More Information:


Planning and Transportation Department
812.349.3423
