Page last updated on February 24, 2025 at 8:13 am
What is a Neighborhood Greenway?
Neighborhood Greenways are low-speed, low-volume, shared-space streets that support high comfort walking and bicycling connections. Our 2019 Transportation Plan designates several City streets for the design and installation of Neighborhood Greenway facilities as part of the Priority Bicycle Facilities Network. To design and install Neighborhood Greenways, the City follows the Staff-led Traffic Calming and Neighborhood Greenways process.
What should I expect?
Neighborhood Greenways are an important component of the community’s plans to support an improved quality of life and connectivity. Past Neighborhood Greenway projects have shown an increase in the number of people walking, rolling, and bicycling in the area.
Residents may still park and drive on the Neighborhood Greenway. Traffic calming devices such as speed bumps and bump outs reduce the likelihood that drivers will speed on these streets.
More information on the Traffic Calming and Greenways process.

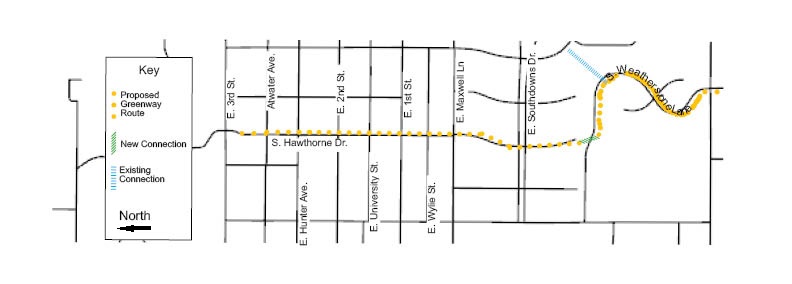

Project Map
Project Timeline
1. Informational Neighborhood Letter- sent 3/18
2. Neighborhood Greenway Survey Completed
Note: Letters were mailed to residents within 300ft of the project - not 300m
3. First Public Meeting: Project Scope and Objectives - Monday, March 28, 2022
4. Second Public Meeting: Design Review and Feedback - Monday, October 24, 2022
5. Third Public Meeting: Design Review and Feedback - Thursday, December 8, 2022 (Video Recording of Meeting) (PowerPoint)
6. May 31 - June 30, 2023: open comment period.
7. Bicycle and Pedestrian Safety Commission Review: Monday, August 14 at 5:30pm
8. September 11, 2023: Bicycle and Pedestrian Safety Commission voted 7-0 to approve the design of the greenway.
9. November 28th, 2023: The project was advertised for construction bidding.
10. December 19th, 2023: The Board of Public Works awarded a construction contract to E&B Paving.
11. February 17, 2024: Mayor Thomson hosts public meeting announcing the impending commencement of the project.
12. The project was awarded to E&B Paving(sole bidder) out of Bloomington for the total amount of $873,378.00.
13. Starting June 2024, and the project will last up to 100 days.
Construction Bidding
Note that this project has two plan sets (one for Hawthorne/Weatherstone and one for Miller). Quantities for both plan sets are included in the item list within the bid packet.
Hawthorne and Weatherstone Final Tracings
(Disclaimer; all documents are for reference only. Official documents are located on OpenGov.)
- Letting Date: 3:00 pm EST Friday, December 15th, 2023 in the McCloskey Room of City Hall at the Showers Building, 401 N. Morton Street, Bloomington, Indiana, and via Zoom by using the following link: https://bloomington.zoom.us/j/82966780199?pwd=LgizbHaY5etiwuTnuHGNgUrnbKrB0g.1
- Award Date: December 19th, 2023, regular meeting of the Board of Public Works which will be held in the Council Chambers of City Hall at the Showers Building, 401 N. Morton Street, Bloomington, Indiana, and via Zoom using the following link: https://bloomington.in.gov/boards/public-works, or a subsequent meeting of the Board of Public Works
On December 19, 2023 at the Board of Public Works meeting this project was awarded to E&B Paving of Bloomington for the amount of $873,378.00.
For More Information
For planning and process questions, contact Hank Duncan, Bicycle and Pedestrian Coordinator, at hank.duncan@bloomington.in.gov
For construction and bidding questions, contact Jeremy Inman, Project Manager Engineering Department, at jeremy.inman@bloomington.in.gov or at 812-349-3913.
